Commercial real estate development is the process of converting land, an existing building, or an underused property into a project that meets market demand and creates value. It covers site selection, underwriting, due diligence, entitlements, design, financing, construction, and disposition, not construction alone.
This guide is for developers, investors, builders, landowners, and commercial property owners across the United States. Each stage carries its own risks: entitlement delays, financing gaps, construction overruns, or a market that shifts before lease-up. We'll walk through the full process, the factors that determine feasibility, and when redevelopment, adaptive reuse, or a sale makes more sense than building from scratch.
Key Takeaways
- Development runs from site selection through feasibility, design, entitlements, financing, construction, and stabilization or exit.
- Zoning, access, utilities, environmental conditions, and financing all require verification before major capital commitments.
- Entitlement requirements and timelines vary by state, county, and city.
- A physically attractive site still needs a defensible financial model and realistic exit plan.
- Understanding a property's highest-and-best use before selling or partnering strengthens a landowner's negotiating position.
What Is Commercial Real Estate Development and Why Is It Used?
Commercial real estate development differs from investing, brokerage, property management, and construction contracting. Investors buy income-producing assets that already exist. Brokers arrange transactions. Contractors build to someone else's plans.
Developers do something different: they coordinate the entire lifecycle, from raw site or vacant building to a finished, income-producing, or sellable property.
Development projects span a wide range of asset types:
- Office, retail, and industrial
- Hospitality and multifamily
- Mixed-use and medical
- Build-to-suit projects designed for a specific occupant
- Redevelopment and adaptive reuse of existing structures
The intended outcome varies by owner and project. Some developers build to hold and lease. Others build to sell units or a stabilized asset. Some are simply improving an underused site or capturing value through entitlements and infrastructure before ever breaking ground.
The Developer's Coordinating Role
A developer sits at the center of a web of relationships: owners, brokers, lenders, architects, engineers, attorneys, municipalities, contractors, and future tenants or buyers. These parties rarely move in sync without coordination. The developer keeps the project moving by sequencing decisions correctly.
That coordination is also why development isn't a single path. Common project forms include:
- Ground-up construction on a raw site
- Conversion or expansion of an existing building
- Full redevelopment of underused property
- Entitlement work that raises land value before a sale
The right approach depends on the site's physical condition, the local market, available capital, and the intended use.
Why the Process Needs Structure
Early assumptions about demand, allowable use, site capacity, and cost drive every decision that follows. Get the zoning wrong, misjudge the market, or skip an environmental check, and those errors compound.
Consider what happens when a buyer closes on land before confirming zoning, utility access, or environmental conditions:
- The intended use may not be permitted
- Utility connections may cost far more than budgeted
- Environmental contamination may trigger remediation obligations
- Title issues may block financing or resale
A structured process controls these risks—and is often mandatory. Lenders, municipalities, building codes, environmental regulations, and contracts all dictate what a developer must document and when.
How the Commercial Real Estate Development Process Works
Commercial real estate development rarely moves in a straight line. Phases overlap, and projects often circle back when feasibility numbers shift, approvals stall, or market conditions change.

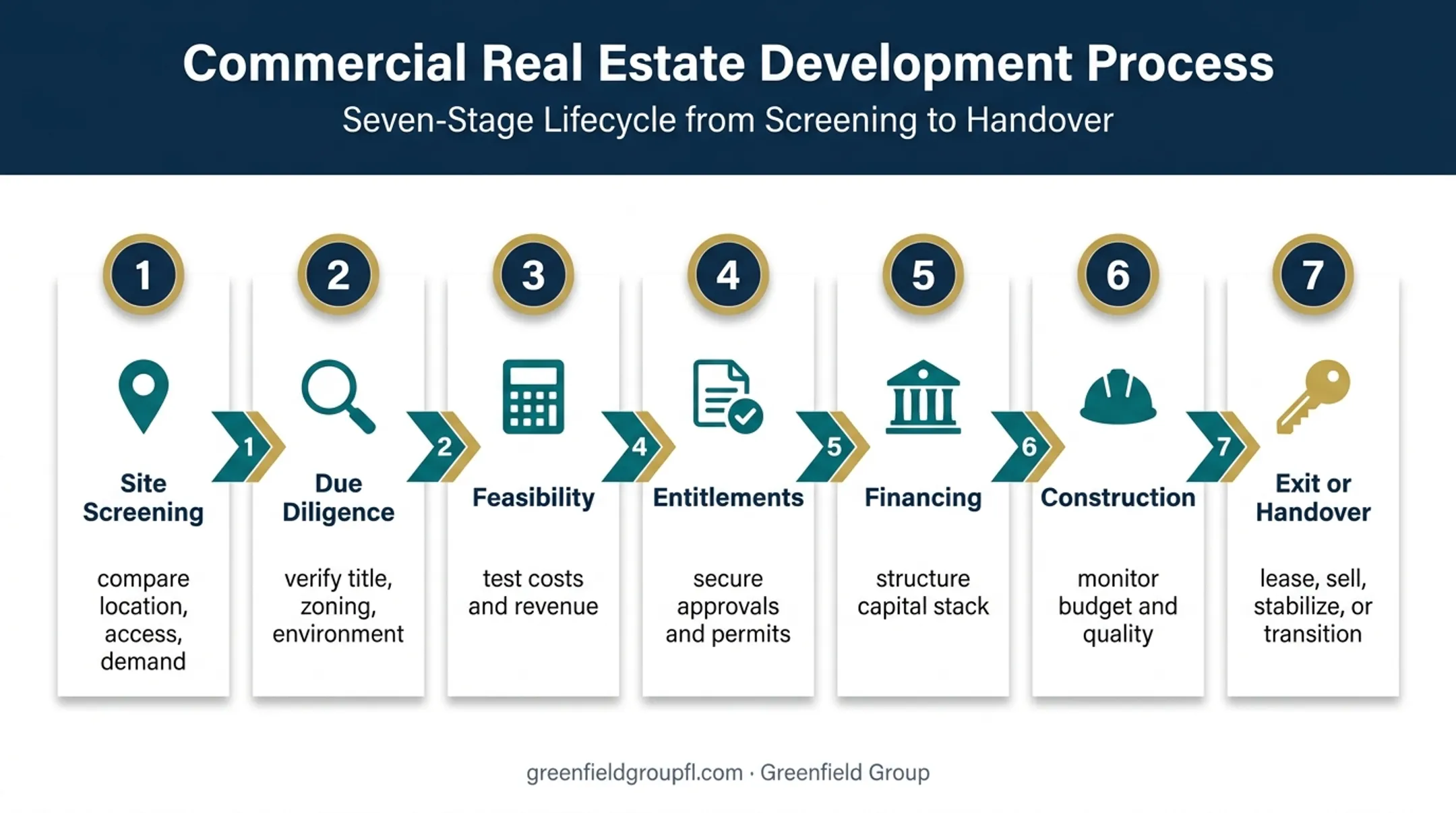

Step 1: Identify and Screen the Site
Developers compare location, parcel size, visibility, access, surrounding uses, competition, demographics, and infrastructure against the proposed product type. A retail concept needs traffic counts and rooftops nearby. Industrial needs highway access and power capacity.
Highest-and-best-use analysis is central here. This test asks whether a use is physically possible, legally permitted, financially feasible, and maximally productive. The answer might point toward commercial development, residential use, redevelopment, or simply selling the property as-is.
Step 2: Establish Site Control and Complete Due Diligence
Site control typically comes through a letter of intent, purchase agreement, or option, structured with contingencies that give time to investigate before closing.
Core diligence items include:
- Title, survey, easements, and encroachments
- Zoning and permitted uses
- Environmental conditions (often starting with a Phase I environmental site assessment)
- Geotechnical conditions, flood exposure, and drainage
- Access, utilities, taxes, liens, and existing leases
Preliminary site plans, conceptual architecture, and early municipal conversations test whether the project actually fits the property, both physically and legally, before the buyer is locked in.
Step 3: Test Feasibility and Build the Preliminary Pro Forma
The preliminary pro forma compares total project costs against expected revenue or sale proceeds. Those costs typically include acquisition, professional fees, entitlements, financing, infrastructure, construction, insurance, taxes, leasing, and closing.
Sensitivity testing matters here. What happens if rents come in 10% below projection? If construction costs rise? If approvals take an extra year? A model that only works under best-case assumptions isn't a model worth financing.
This is also where developer-level underwriting earns its keep. Greenfield Group reviews zoning, entitlements, utilities, and highest-and-best-use potential on Florida development sites. For qualifying listings, preliminary site plans, architectural concepts, and engineering analysis are available before a property reaches the broader market.
Step 4: Design the Project and Secure Entitlements
Architects, civil and structural engineers, and traffic and environmental consultants coordinate a concept and submission package. Entitlement work can include:
- Zoning verification or rezoning
- Conditional or special-use approvals and variances
- Site-plan review and subdivision or platting
- Utility and environmental approvals
- Design review, public meetings, and building permits
Entitlement isn't guaranteed. Approval paths, submission requirements, and timelines vary by jurisdiction, and public hearings can add months. Confirming the process with local planning staff early avoids surprises later.
Step 5: Structure Financing and Finalize the Deal
The capital stack usually blends sponsor equity, outside investor equity, preferred equity, senior debt, and sometimes mezzanine or bridge financing for construction.
Lenders and equity partners evaluate sponsor track record, site control, approvals secured, budget accuracy, projected cash flow, and the exit plan.
Lending activity has picked up recently. CBRE reported a 13% quarter-over-quarter and 90% year-over-year increase in its commercial lending index in Q1 2025, with an average underwritten loan-to-value ratio of 62.2% across measured closings.
That figure reflects broader market activity, not a guaranteed term for any specific project.
Before closing, the final budget should incorporate updated contractor bids, soft costs, contingencies, carrying costs, and reserves.
Step 6: Construct, Monitor, and Control the Project
Construction starts with contractor selection, scope definition, and scheduling, then moves through mobilization, site prep, foundations, vertical construction, and interiors.
The developer's job during this phase:
- Track budget against draw requests
- Monitor quality and respond to requests for information
- Manage change orders and disputes
- Coordinate safety and respond to delays
Cost pressure is real. Turner's U.S. building cost index reached 1,476 in Q2 2025, up 1.17% from the prior quarter. Construction completion isn't project completion, either. Punch lists, inspections, testing, and final documentation still need to close out.
Step 7: Lease, Sell, Stabilize, or Hand Over the Property
The exit strategy chosen at the start determines the work required at the end. Pre-leasing and tenant improvements matter for a hold-and-lease project. Presale contracts and closing coordination matter for a for-sale project.
Once a certificate of occupancy (or local equivalent) is issued, close-out includes warranties, as-built drawings, maintenance manuals, and the transition to ownership or property management.

Where the Commercial Real Estate Development Process Applies
This process applies far beyond raw land. It's relevant for vacant commercial parcels, older buildings, surplus institutional property, assembled lots, and underperforming assets sitting on land worth more than the structure on it.
Complexity scales with project size. A small infill redevelopment might need a handful of studies. A large mixed-use or master-planned community needs traffic studies, phased entitlements, and multi-year infrastructure planning.
Common triggers for starting development analysis:
- Population or employment growth in the trade area
- Changing tenant demand or obsolete improvements
- New infrastructure investment nearby
- A zoning opportunity that wasn't previously available
- An owner needing to sell or a developer seeking a build-to-suit site

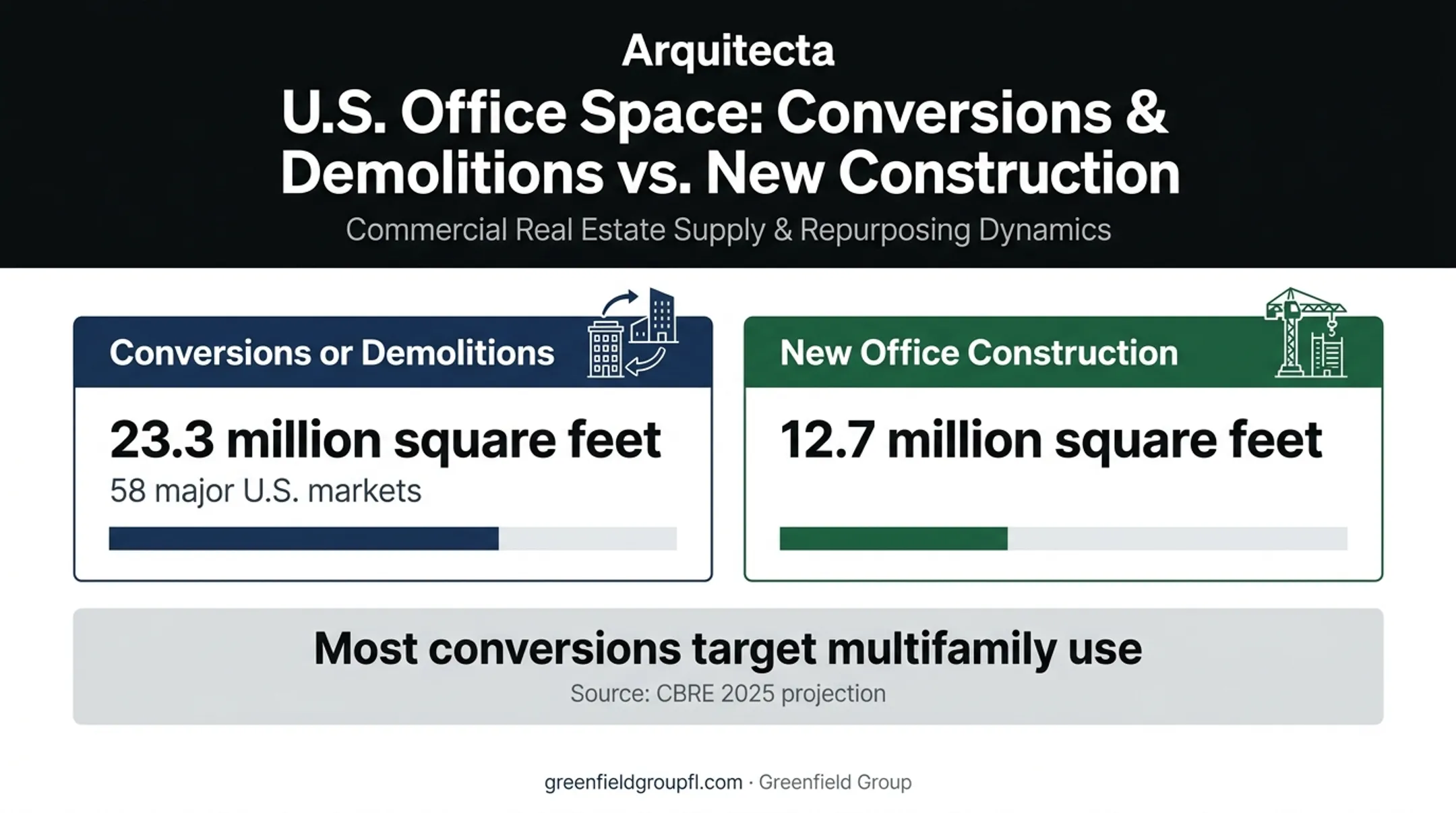

Development doesn't always mean new construction. According to a 2025 CBRE projection, 23.3 million square feet of office space was set for removal through conversion or demolition across 58 major U.S. markets. That exceeds the 12.7 million square feet of new office construction, and most conversions target multifamily use.

Common paths worth comparing:
- Ground-up development — best when the site is clean, entitled use aligns with demand, and construction costs pencil
- Adaptive reuse — repurposing an existing structure for a new use, often faster than ground-up
- Redevelopment — replacing existing improvements entirely
- Entitlement and resale — securing approvals, then selling to a builder without constructing
- Landowner-builder joint ventures — pairing land with a homebuilder's capital and execution
For Florida landowners specifically, this last path is common with churches, institutional owners, and families holding surplus or inherited acreage who'd rather partner than sell outright.
Key Factors, Risks, and Common Misconceptions

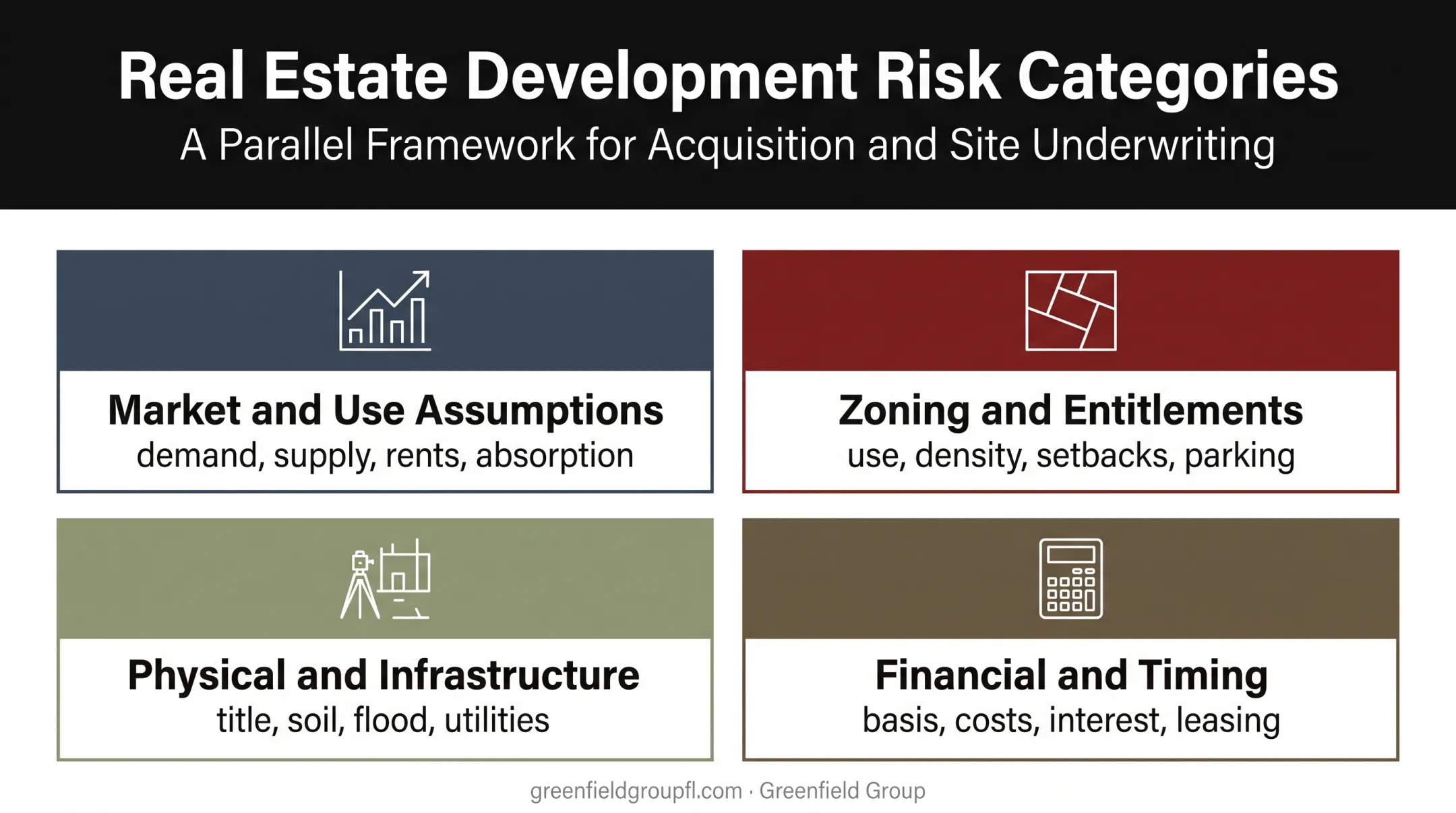

Several categories of risk determine whether a project actually works.
Market and use assumptions. Demand, competing supply, achievable rents, and absorption all need location-specific research. An attractive site can still fail if the product is oversized, poorly timed, or can't compete with existing inventory.
Zoning and entitlements. Permitted use, density, setbacks, parking, and design standards vary by jurisdiction. A broker's opinion or seller's representation isn't a substitute for written confirmation from the relevant authority.
Physical and infrastructure conditions. Title issues, soil conditions, flood exposure, and undersized utilities can force a redesign, add off-site costs, or make a project infeasible altogether.
Financial and timing risk. Land basis, hard and soft costs, escalation, interest carry, and leasing costs all need current, researched figures rather than rough estimates.

Two misconceptions cause the most damage:
- "I own the land, so I can build what I want." Zoning, entitlements, physical constraints, and market demand all control what's actually buildable.
- "This rendering proves the numbers work." A conceptual drawing or yield estimate isn't a guaranteed approval, valuation, or return.
Even with sound assumptions, development isn't always the right move. It may not fit when the site can't support the intended use, approvals cost more than the opportunity justifies, or the owner's goals are better served by selling, leasing, or partnering instead.
Watch for these warning signs:
- An unresolved diligence finding
- A pro forma nobody can defend
- A project moving forward with no credible exit plan
Legal, tax, engineering, environmental, and lending professionals should weigh in on project-specific decisions.
Conclusion
Commercial real estate development is a coordinated process: it takes a site or existing asset and turns it into something legally permitted, financially supportable, built, and marketable.
The most important work usually happens before construction ever starts—in selecting the right use, validating the site, testing the numbers, and understanding what the approval path will require.
Development isn't the automatic answer for every property. Depending on the site and the owner's goals, redevelopment, adaptive reuse, a joint venture, or a well-prepared sale might deliver a better outcome.
For owners sitting on a difficult-to-value Florida property, Greenfield Group offers underwriting-led analysis of highest and best use, entitlements, and utilities before that asset ever reaches the market. That work clarifies what the asset is actually worth to a developer.
Frequently Asked Questions
What does a commercial property developer do?
A developer coordinates site selection, feasibility analysis, financing, design, approvals, construction, and leasing or sales. They manage risk across the entire project rather than performing every technical task themselves.
What can be built on commercial land?
Allowable development depends on zoning, comprehensive plans, entitlements, site constraints, and market feasibility. Always confirm specific requirements with the relevant local jurisdiction before assuming a use is permitted.
What are the four types of commercial real estate?
Office, retail, industrial, and multifamily are the most commonly cited categories. Hospitality, medical, mixed-use, and other specialty properties are also frequently classified as commercial real estate.
What is the most profitable type of real estate development?
Profitability depends on location, demand, cost basis, financing terms, execution, and timing rather than one universally best property type. The same asset class can perform very differently across markets.
Is it a good idea to invest in commercial property?
Commercial property can generate income and build value, but it carries vacancy, financing, construction, and regulatory risk. Property-specific due diligence is essential before committing capital.
What does "commercial development" mean?
It refers to the planning, approval, financing, construction, redevelopment, or repositioning of property for business, income-producing, or institutional uses rather than primarily residential purposes.
